Week 14 — Probability modeling project

Modeling a question with simulation and theory — a workshop orientation

The week question

By now you have built quite a toolkit. You can lay out a sample space, condition on information, update with Bayes’ rule, name a discrete or continuous model, summarize it with a mean and variance, and watch averages settle down by simulation. The project week asks a different kind of question — not “can you apply the right formula?” but “given a question you care about, can you build a probability model for it, reason with it honestly, and report what it does and does not tell you?”

This is a workshop, not a new chapter. There is no fresh distribution to memorize. The content this week is the modeling process itself: how to take a vague real question, turn it into something a probability model can answer, check the model against a simulation, and communicate the conclusion together with its uncertainty and its assumptions. The skill you are practicing is the one that outlasts any single formula — the move from a messy question to a defensible, clearly-stated answer.

Why this matters

Every formula you have learned this semester answers a question someone first had to pose as a probability question. That posing step — deciding what the random thing is, what counts as the sample space, which assumptions you are willing to make — is where most of the real reasoning happens, and it is exactly the part a textbook problem usually does for you. The project hands that part back to you.

It matters because the honest version of any quantitative answer is never just a number; it is a number plus the assumptions that produced it. A model that says “about a 24% chance” is only as trustworthy as the assumptions underneath it, and a careful modeler names those assumptions out loud so that a reader can judge them. Learning to say “here is my estimate, here is how I got it, and here is where it might be wrong” is the most transferable thing in this course. It is what separates a calculation from a conclusion.

The process also travels far beyond probability. The same loop — pose, assume, model, check, communicate — is how questions get answered in public health, engineering, finance, and research. You are practicing a general way of thinking that happens to use the probability machinery you already built.

Learning goals

By the end of this week you should be able to:

  • Take an informal question and frame it as a precise probabilistic question, naming the random variable and the event you actually want the probability of.
  • State the sample space and the modeling assumptions explicitly, including the simplifications you are knowingly making.
  • Build either a probability model (a named distribution or an explicit pmf/density) or a simulation that estimates the same quantity — and ideally both.
  • Compare a simulated estimate to a theoretical value where one is available, and explain why they should agree.
  • Communicate a conclusion with its uncertainty and its assumptions, naming at least one limitation of the model in plain language.

Core vocabulary

  • Probabilistic question — a question phrased so that its answer is a probability, an expectation, or a distribution: “what is \(P(\text{at least two late days})\)?”, not “is Maya often late?”
  • Modeling assumption — a claim you adopt to make the model tractable (independence, a constant rate, a particular distribution). Assumptions are not facts; they are choices you are responsible for naming.
  • Simplification — an assumption you know is not exactly true but adopt anyway because it makes the problem solvable and is “close enough” for the question. The honest move is to flag it, not hide it.
  • Theoretical result — a probability obtained by reasoning from the model’s structure (a pmf, a formula).
  • Simulated estimate — a probability obtained by generating many synthetic outcomes and counting the fraction in which the event occurs. It approximates the theoretical value and improves with more draws (the Week 13 law of large numbers).
  • Limitation — a specific, named way the model could be wrong or could mislead, stated so a reader can weigh it.

Concept development

Step one — pose a precise question and name the sample space

The hardest and most important step comes first: turning a vague question into a precise one. “How often is Maya late?” is not yet answerable, because “often” is undefined and the time frame is unstated. A modeler sharpens it into something a model can answer — for instance, “Over a five-day school week, what is the probability she is late on at least two of the days?” Now there is a clear random quantity (the number of late days in a week, \(0\) through \(5\)) and a clear event of interest (\(\{\text{late days} \ge 2\}\)).

With the question sharp, the sample space follows. Here an outcome is a five-day record of late/on-time — something like (late, on time, on time, late, on time) — and the number of late days is a count from \(0\) to \(5\). Naming the sample space forces you to decide what an “outcome” even is, which in turn surfaces the assumptions you are about to make. Skipping this step is how people end up computing the right formula for the wrong question.

Step two — choose a model: theory, simulation, or both

Once the question and sample space are fixed, you build something that produces probabilities. You have two routes, and a strong project uses both as a cross-check.

The theoretical route asks: does a named model fit? If the five days are independent and each has the same probability \(p\) of a late arrival, then the number of late days is a count of successes in a fixed number of independent yes/no trials — exactly the binomial recognition from Week 9. That gives a pmf you can compute directly.

The simulation route asks: can I generate many synthetic weeks and just count? You draw, say, ten thousand five-day weeks under the same assumptions, count how often at least two days are late, and report that fraction. No closed form is required; the law of large numbers (Week 13) says the fraction converges to the true probability as the number of simulated weeks grows.

When both routes are available, run both. If the simulated fraction lands close to the theoretical probability, that agreement is strong evidence you implemented both correctly. If they disagree, you have found a bug in one of them — which is itself a useful result.

Step three — compare, then communicate with uncertainty and assumptions

A number alone is not a conclusion. The final step is to put the result in words a reader can act on, and to attach to it the things that could change it.

Communicating uncertainty means acknowledging that a simulated estimate is itself approximate (a different seed gives a slightly different fraction) and that the underlying probability is a modeled quantity, not a measured one. Communicating assumptions means stating, in plain language, what you assumed and where it might fail. The single most valuable sentence in a probability project is often the one that begins “this answer assumes that…” — because it tells the reader exactly how much to trust the number and under what conditions it would break.

That habit — answer, then caveat — is what we practice in the worked examples below. The project on Blackboard asks you to carry the same loop through on a question of your own.

Worked examples

Worked example — Maya’s late days, theory then simulation (recurring slice)

Take the sharpened question: over a five-day week, what is the probability Maya is late on at least two days? We model it two ways.

Theory. Suppose — and this is an assumption we will scrutinize in a moment — that the five days are independent and each has the same late probability \(p = 0.19\), the marginal \(P(\text{late})\) from our recurring shuttle case. Then the number of late days \(L\) is a count of “successes” (late = success here) in \(n = 5\) independent, identical yes/no trials, which is binomial:

\[ L \sim \text{Binomial}(5,\ 0.19), \qquad p(k) = \binom{5}{k}\,(0.19)^{k}\,(0.81)^{5-k}, \quad k = 0, 1, 2, 3, 4, 5. \]

The event “at least two late days” is easiest by the complement — subtract the chances of zero or one late day from \(1\):

\[ P(L \ge 2) = 1 - P(L = 0) - P(L = 1). \]

Compute the two small terms:

\[ P(L = 0) = (0.81)^{5} \approx 0.3487, \qquad P(L = 1) = \binom{5}{1}(0.19)(0.81)^{4} = 5(0.19)(0.4305) \approx 0.4090. \]

So

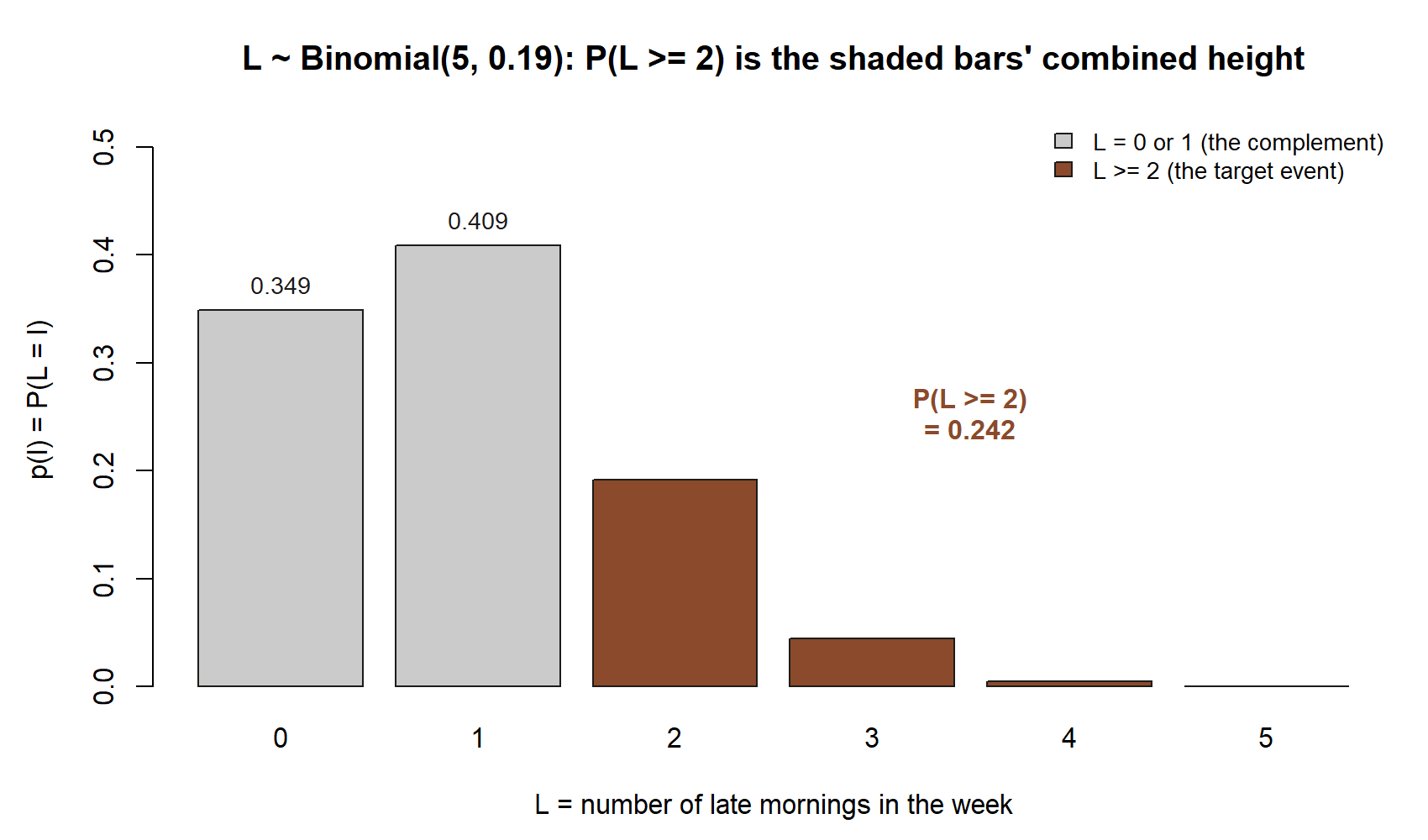

\[ P(L \ge 2) = 1 - 0.3487 - 0.4090 \approx 0.24. \]

About a 24% chance — roughly one week in four — that Maya is late on two or more days, under the independence assumption. (Synthetic scenario; numbers fixed for the course.)

Simulation. We can estimate the same probability without the pmf by generating many synthetic weeks and counting. The chunk below is shown as teaching, not run here; when executed it draws ten thousand five-day weeks and reports the fraction with at least two late days, which should land near \(0.24\).

set.seed(35003)
weeks <- 10000                  # number of synthetic 5-day weeks (synthetic; seed set)
p_late <- 0.19                  # modeled P(late) per day, from the recurring shuttle case

# each row is a week; rbinom counts late days in 5 independent trials with prob p_late
late_days <- rbinom(weeks, size = 5, prob = p_late)

# fraction of weeks with at least two late days — the simulated estimate of P(L >= 2)
est <- mean(late_days >= 2)
est                             # should be near the theoretical 0.24

# theoretical value for comparison, via the complement on the binomial pmf
theory <- 1 - dbinom(0, 5, p_late) - dbinom(1, 5, p_late)
theory                          # ~0.2423; compare to est above

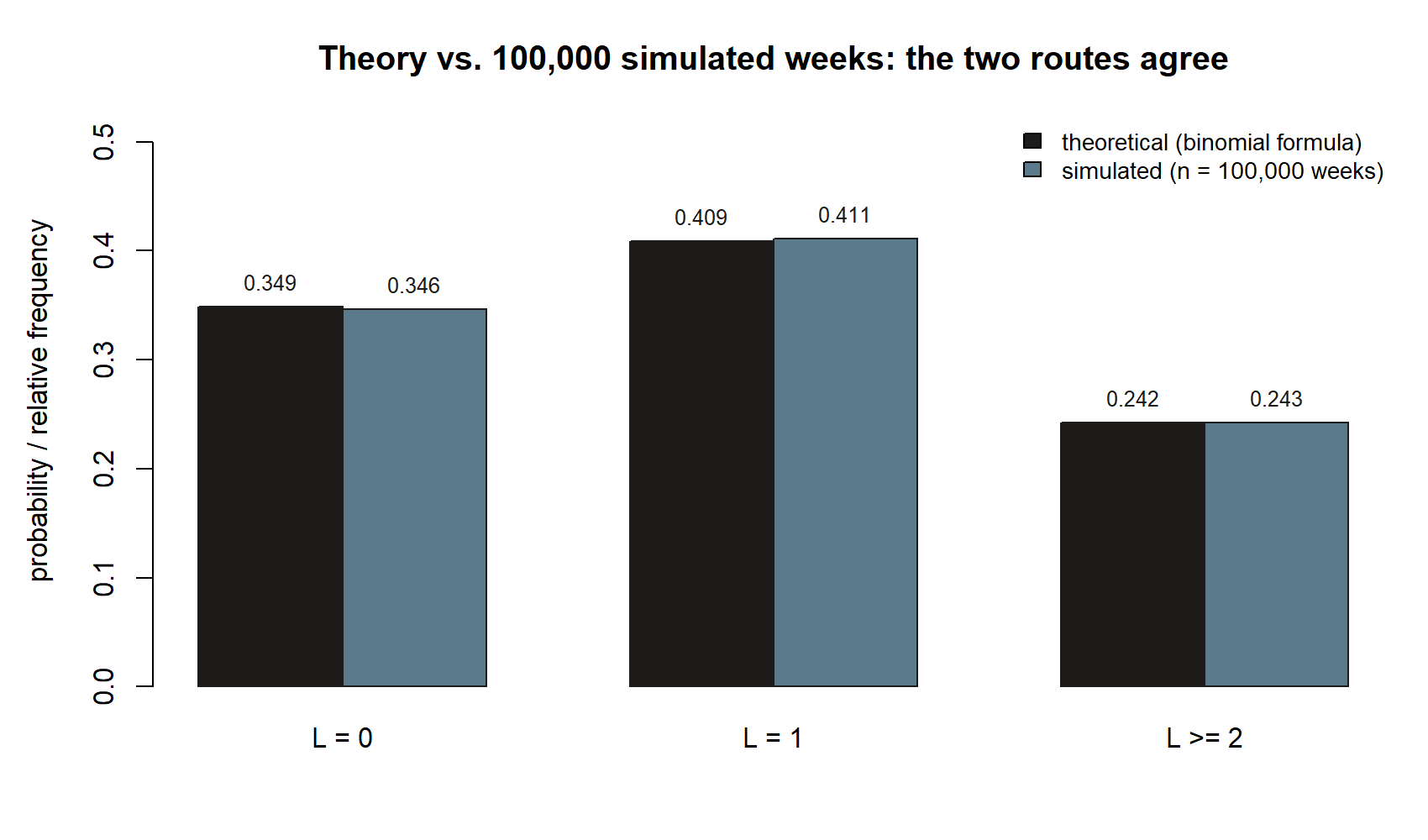

The point of running it both ways is the comparison. Theory gives \(\approx 0.24\) exactly from the model; the simulation gives an estimate that wobbles slightly with the seed but lands close. Agreement is the cross-check that says both the formula and the code encode the same model.

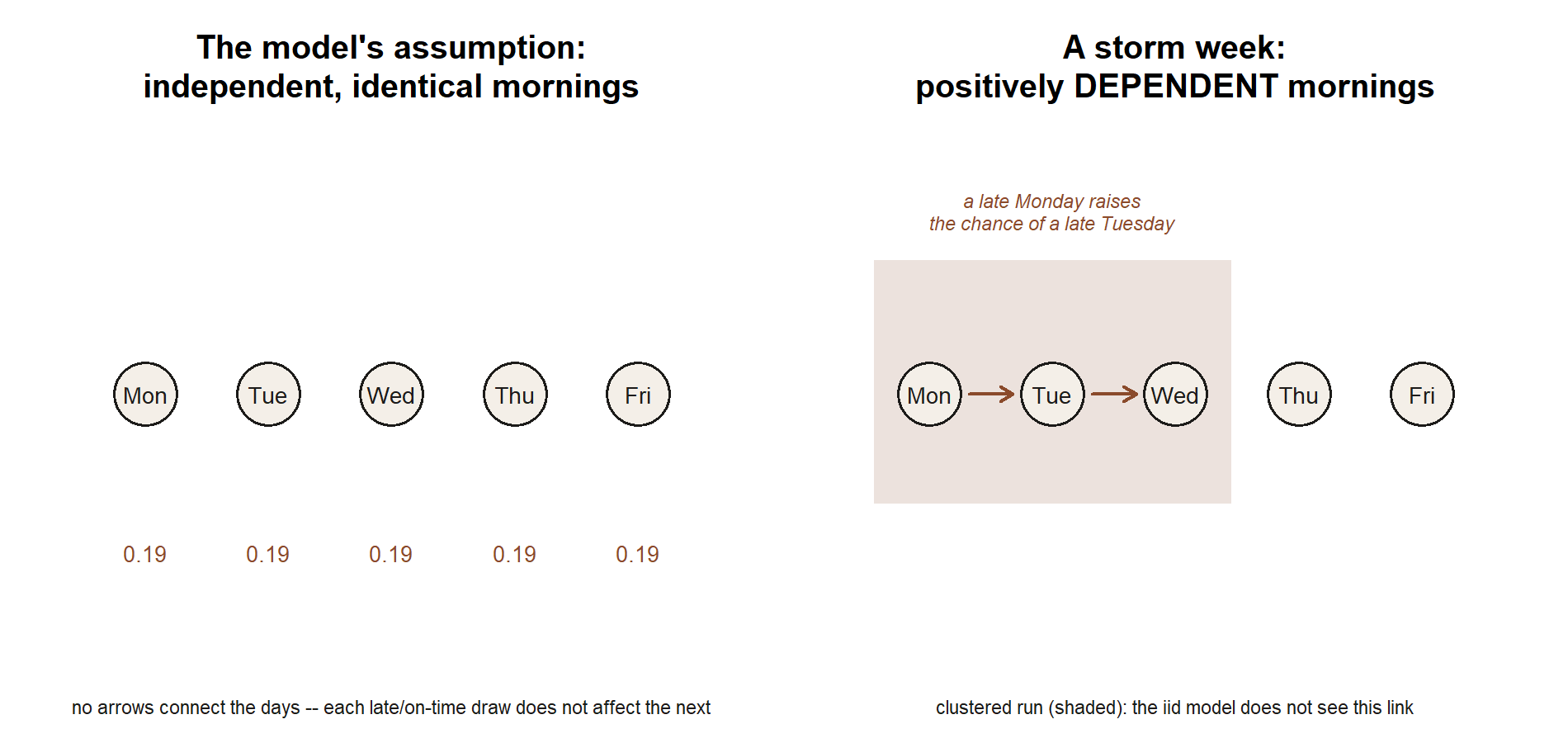

Now the limitation — and this is the key teaching point of the week. The whole calculation rests on the assumption that the five days are independent with the same \(p = 0.19\). But back in Weeks 3 and 4 we established that lateness in our world is not independent of rain: \(P(\text{late} \mid \text{rain}) = 0.40\) while \(P(\text{late} \mid \text{no rain}) = 0.10\), and rain itself tends to come in multi-day stretches. If it rains Monday it is more likely to rain Tuesday, so late days will cluster rather than fall independently. Treating the days as independent is therefore a modeling simplification, not a fact about the world. Naming it changes how we report the answer: rather than “the probability is 24%,” the honest statement is “under the simplifying assumption that days are independent with a constant 19% late rate, the model gives about 24%; because rain makes late days cluster, the true chance of two-or-more late days in a rainy stretch is probably somewhat higher than this figure suggests.” That caveat is not a weakness in the project — it is the project. A reader who knows the assumption can judge the number; a reader who does not is being misled by a tidy-looking 24%.

Worked example — a help-desk staffing question (transfer)

Now carry the same loop to a new context. A small IT help desk wants to know: on a given morning, what is the probability that more than six support requests arrive in the first hour? We frame and model it.

Pose. The random quantity is the number of requests in one hour; the event is \(\{\text{count} > 6\}\).

Sample space and assumptions. An outcome is a count \(0, 1, 2, \dots\). We assume requests arrive at a steady average rate and do not coordinate with one another — the Poisson assumptions from Week 9 — with a historical average of \(\lambda = 5\) per hour. Then the count \(N \sim \text{Poisson}(5)\).

Theory. “More than six” is again cleanest by the complement, \(P(N > 6) = 1 - P(N \le 6)\), summing the Poisson pmf from \(0\) through \(6\):

\[ P(N > 6) = 1 - \sum_{k=0}^{6} \frac{e^{-5}\,5^{k}}{k!} \approx 1 - 0.762 = 0.238. \]

So about a 24% chance of a busier-than-usual first hour. (The numerical resemblance to Maya’s answer is a coincidence of the chosen numbers — synthetic scenario, numbers fixed for the course.)

Simulation. Drawing many synthetic hours from rpois(hours, lambda = 5) and counting the fraction above six would estimate the same \(0.238\), converging as the number of simulated hours grows — the same theory-versus-simulation cross-check as before.

Communicate, with the limitation. The honest report names the assumption: “assuming requests arrive at a steady rate of 5 per hour and independently, roughly one morning in four sees more than six in the first hour.” And the limitation is real — if requests spike right after a system outage or at the start of a semester, the rate is not constant, the Poisson model understates the busy mornings, and staffing planned on the 24% figure would be caught short. Same loop, new question: pose, assume, model, check, communicate the number with its caveat.

A common mistake

The most common mistake this week is reporting the number and stopping — handing over “24%” as if it were a measured fact rather than a modeled estimate that depends on assumptions you chose. The fix is a discipline: every probability answer in this project should be followed by a sentence that names at least one assumption and one way the model could be wrong. A close cousin of this mistake is hiding a simplification — quietly assuming independence (as in Maya’s late days) without telling the reader, which makes the answer look more solid than it is.

A second, more technical slip is treating a simulated estimate as exact. The simulation gives an approximation that depends on the seed and the number of draws; running it again with a different seed gives a slightly different fraction. That is not a flaw — it is the law of large numbers in action — but it means you should describe the simulated result as “about” a value, not as the value, and lean on the theoretical computation when one is available. The two routes are partners: theory gives the exact answer for the model, and simulation confirms you built the model correctly.

Low-stakes self-checks (ungraded)

These are for your own practice — ungraded, no submission, just a way to rehearse the modeling moves before you take them into a project of your own.

  1. Rewrite the vague question “is the bus usually crowded?” as a precise probabilistic question. (One good version: “on a weekday afternoon, what is \(P(\text{more than 40 riders})\)?” — it names a random quantity and an event.)
  2. In Maya’s late-days model, we used the complement to get \(P(L \ge 2)\). Why is the complement easier than adding \(P(L=2) + P(L=3) + P(L=4) + P(L=5)\)? (Only two small terms, \(P(L=0)\) and \(P(L=1)\), versus four.)
  3. Name one assumption in the help-desk Poisson model and one realistic situation that would break it. (Constant rate; a post-outage spike or a first-day-of-class rush makes the rate non-constant.)
  4. If your simulation of Maya’s weeks returned \(0.241\) and your theory gave \(0.2423\), is that a problem? (No — the simulated estimate is expected to wobble near the theoretical value; close agreement is the cross-check working.)
  5. State, in one sentence, the conclusion of Maya’s late-days model with its main limitation. (For example: “about a 24% chance of two-or-more late days, assuming days are independent — likely an underestimate during rainy stretches when late days cluster.”)

You can rehearse the simulation half of this loop in the Week 13 simulation lab, Lab 13 — Law of large numbers and the CLT, where the same draw-many-and-count pattern appears.

Reading and source pointer

This workshop week does not track a single Grinstead & Snell chapter; it is course-original, weaving together the modeling ideas spread across the semester’s reading — sample spaces (Ch 1), independence and conditioning (Ch 4), the named discrete models (Ch 5), and the law of large numbers (Ch 8) that justifies estimating a probability by simulation. The “build a model, then check it against a simulation” posture is supported by the simulation and model-checking themes in MIT OCW 18.05. These notes are the course’s own synthesis, grounded in but not copied from the sources. All scenario data are synthetic, with the seed set.seed(35003) fixed in the shown simulation.

Public vs. graded

These notes, the examples, and the practice here are public and ungraded — study material only. No graded prompts, answer keys, rubrics, point values, or due dates appear on this site. Graded checkpoints, quizzes, homework, labs, the midterm, the project, and the final live in Blackboard (the LMS), which is authoritative for due dates, submissions, and grades. If this page and Blackboard ever disagree, follow Blackboard.

This page describes the modeling process and what a thoughtful project looks like, in qualitative terms only. The actual project — its specific deliverable, expectations, and timeline — lives in Blackboard, which is the authoritative source for everything graded.

Looking ahead

Next week is the final synthesis. Week 15 steps back across the whole semester and follows the recurring commuter’s-morning thread from end to end — from “what does \(P(\text{on time}) = 0.81\) mean?” in Week 1, through conditioning and Bayes, the discrete and continuous models, joint dependence, and the limit behavior — to see how the pieces fit into one coherent way of reasoning under uncertainty. The modeling loop you practiced this week — pose, assume, model, check, communicate — is the frame that holds all of it together.
