Lab 2 — Monte Carlo basics

Estimating a probability by simulating it

Purpose. This lab is the hands-on companion to Week 2 — Sample spaces, events & rules. There you built the shuttle×rain sample space and computed \(P(\text{on time}) = 0.81\) by hand using the addition and complement rules. Here you will reach the same number a completely different way: by simulating Maya’s morning thousands of times and counting how often the shuttle is on time. When the hand calculation and the simulation agree, you trust both more — and you get a first, concrete taste of the law of large numbers.

The idea

A probability is a long-run proportion. When we say \(P(\text{on time}) = 0.81\), one honest reading is: “if Maya took this commute on a very large number of independent mornings, the fraction of mornings the shuttle arrived on time would settle near \(0.81\).” That sentence is not just an interpretation — it is a recipe. If we can act out one morning at random on the computer, we can act out ten thousand mornings, tally the on-time ones, and divide. The resulting fraction is a Monte Carlo estimate of the probability.

Monte Carlo is the name for this whole family of methods: use a stream of random numbers to imitate a random process, then read an answer off the imitation. It is powerful precisely when the hand calculation is hard or impossible. The shuttle problem is not hard — we already know the exact answer is \(0.81\) — and that is exactly why it makes a good first lab. We can check the simulation against the truth and learn to trust the technique before we point it at problems we cannot solve by hand.

The world we are simulating is the same locked synthetic world from the week note. Each morning:

  • It rains with probability \(P(\text{rain}) = 0.30\).
  • If it rains, the shuttle is on time with probability \(P(\text{on time}\mid\text{rain}) = 0.60\).
  • If it does not rain, the shuttle is on time with probability \(P(\text{on time}\mid\text{no rain}) = 0.90\).

Averaging over the weather gives the marginal probability you derived by hand:

\[ P(\text{on time}) = 0.60 \times 0.30 + 0.90 \times 0.70 = 0.81, \qquad P(\text{late}) = 1 - 0.81 = 0.19. \]

All numbers here are synthetic; seed set. Nothing depends on real weather or a real shuttle.

Goal

By the end of this lab you should be able to:

  • Translate a two-stage random process (weather, then shuttle) into a short base-R simulation.
  • Estimate \(P(\text{on time})\) and \(P(\text{late})\) as the mean of a \(0/1\) indicator over many simulated mornings.
  • Compare your simulated estimate to the exact value \(0.81\) and judge whether the gap is “small.”
  • Watch the running estimate settle toward \(0.81\) as the number of replications grows — the law of large numbers in action.
  • Change the inputs (the rain and on-time probabilities) and re-estimate, confirming the simulation tracks whatever world you specify.

This is self-check, ungraded practice. There is nothing to submit here; work the steps, predict each result before you imagine running the chunk, and notice where your prediction and the logic agree.

Setup

You need R and the ability to open a Quarto (.qmd) or plain R script — RStudio or Posit Cloud both work. No add-on packages are required: everything below is base R. The functions we lean on are small and worth knowing by name:

  • set.seed() — fixes the random-number stream so the “random” results are reproducible. Every chunk that draws randomness in this lab starts with set.seed(35003) (the course seed) so your numbers match the discussion.
  • rbinom(n, size, prob) — draws n values, each the count of successes in size independent trials with success probability prob. With size = 1 it is a coin flip returning 0 or 1, which is exactly what we want for a yes/no event like “did it rain?”
  • ifelse(test, yes, no) — a vectorized choice: wherever test is TRUE it returns yes, elsewhere no. We use it to give each morning the right on-time probability depending on whether it rained.
  • mean() — of a vector of 0s and 1s, this is just the proportion of 1s, i.e. our estimated probability.
Note

Here the code is shown, not run. Each chunk is marked #| eval: false, so the page renders the code as teaching without executing it. To actually see the numbers, copy a chunk into your own R session. The chunks are written so that, when executed, the seed makes them reproducible.

Steps

We build the simulation in pieces: first generate the weather, then the shuttle outcome conditional on the weather, then collapse everything to a single estimate, and finally watch that estimate stabilize.

Step 1 — Simulate the weather for many mornings

Pick a number of mornings to simulate — call it n_morn. Start large enough that the estimate is stable (ten thousand is plenty here) but small enough to run instantly. Each morning, rain is a single yes/no trial with probability \(0.30\), so rbinom(n_morn, size = 1, prob = 0.30) gives us a vector of n_morn values, each 1 for rain and 0 for no rain. The mean of that vector should land near \(0.30\), a tiny first check that the draw did what we asked.

set.seed(35003)            # reproducible: course seed

n_morn <- 10000            # number of simulated mornings
p_rain <- 0.30             # P(rain), locked synthetic value

# Draw rain for each morning: 1 = rain, 0 = no rain
rain <- rbinom(n_morn, size = 1, prob = p_rain)

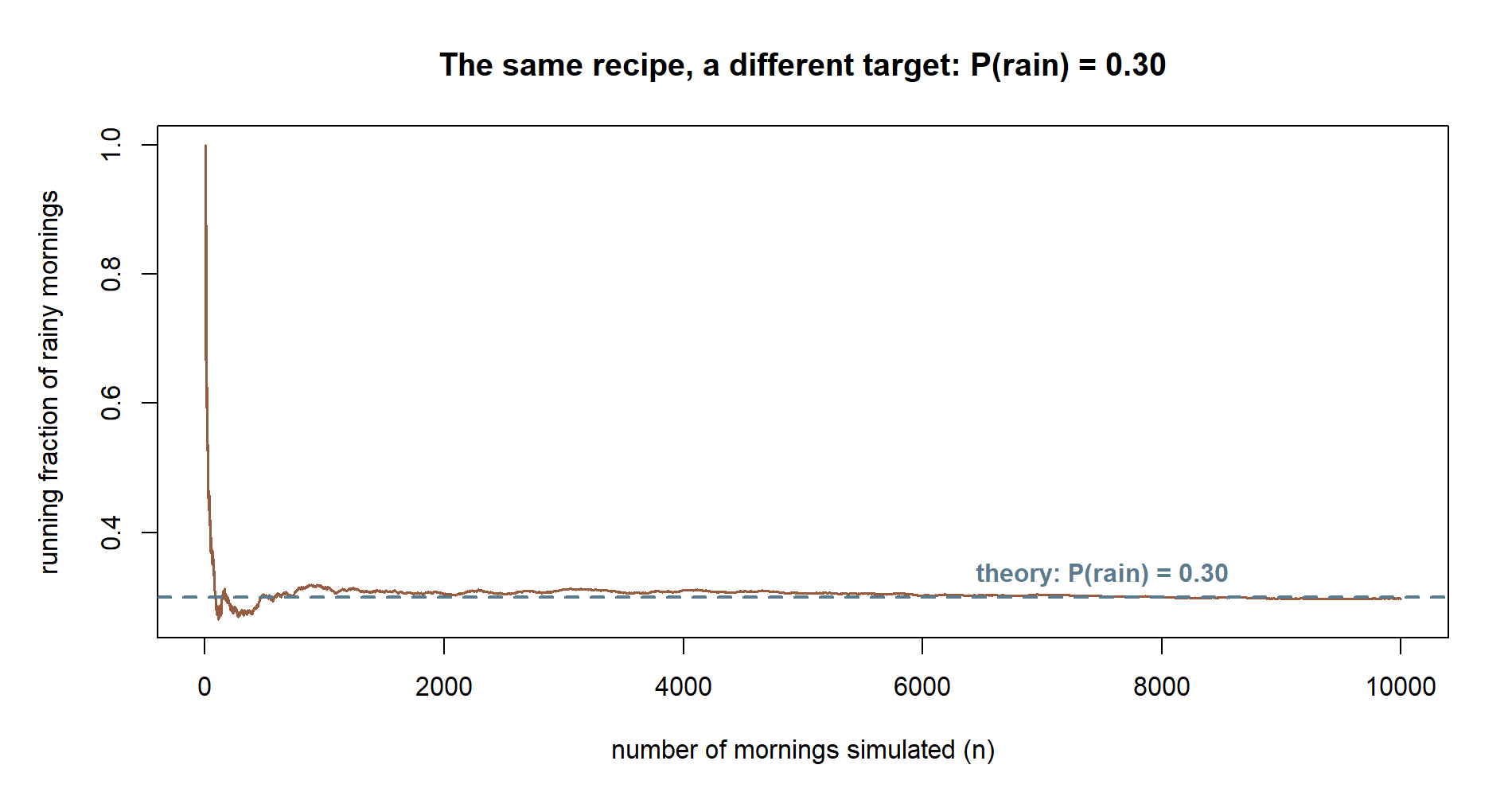

# Sanity check: fraction of rainy mornings should sit near 0.30
mean(rain)

The object rain is now a length-10000 vector of 0s and 1s. We have not touched the shuttle yet — we have only rolled the weather. Keeping the two stages separate mirrors exactly how you built the sample space by hand: branch on the weather first, then on the shuttle.

Step 2 — Simulate the shuttle, conditional on the weather

The shuttle’s on-time probability is not the same every morning; it depends on whether it rained. This conditional structure is the whole point of the week, so the code makes it explicit. For each morning we want the success probability to be \(0.60\) on rainy mornings and \(0.90\) on dry ones. The ifelse() function builds exactly that vector of per-morning probabilities, and then a single call to rbinom() with a vector of probabilities draws one shuttle outcome per morning, each with its own correct probability.

# Per-morning on-time probability depends on rain:
#   rain == 1  -> 0.60
#   rain == 0  -> 0.90
p_ontime <- ifelse(rain == 1, 0.60, 0.90)

# One shuttle outcome per morning: 1 = on time, 0 = late
on_time <- rbinom(n_morn, size = 1, prob = p_ontime)

# Peek at the first few mornings (rain, its on-time prob, the outcome)

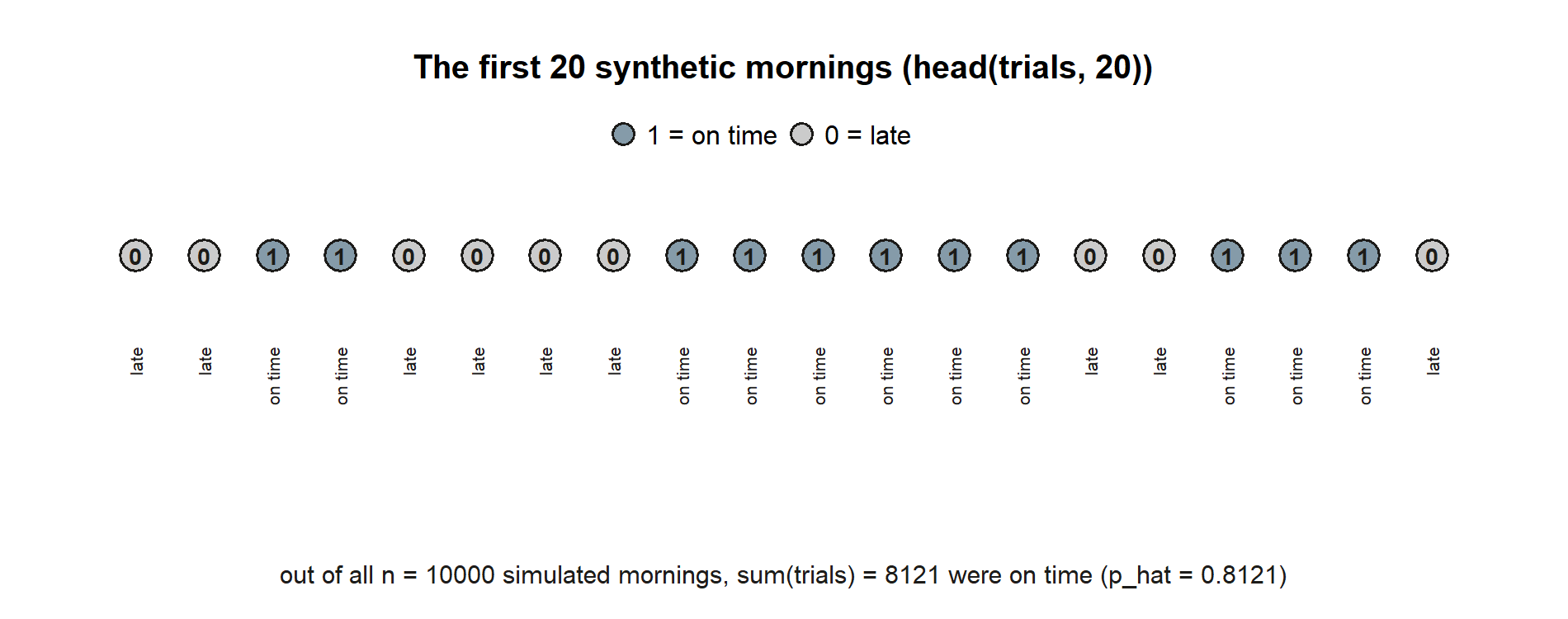

head(data.frame(rain, p_ontime, on_time))

Read that head() output as a tiny logbook of Maya’s first six simulated mornings: the weather, the probability the shuttle “rolled against,” and whether it actually made it on time. Notice that even on a rainy morning the shuttle can be on time, and even on a dry morning it can be late — the randomness lives in the rbinom draw, not in a hard rule.

Step 3 — Estimate P(on time) and P(late)

Now collapse the whole simulation to a number. The vector on_time holds a 1 for every on-time morning and a 0 for every late one, so its mean is the proportion of on-time mornings — our Monte Carlo estimate of \(P(\text{on time})\). The estimate of \(P(\text{late})\) is one minus that, or equivalently the mean of the late indicator. Treating an event’s \(0/1\) indicator and then averaging is the core move of the whole lab; everything else is bookkeeping.

# Estimated P(on time): proportion of mornings the shuttle was on time
p_ontime_hat <- mean(on_time)

# Estimated P(late): the complement (mean of the late indicator)
p_late_hat <- mean(on_time == 0)

p_ontime_hat

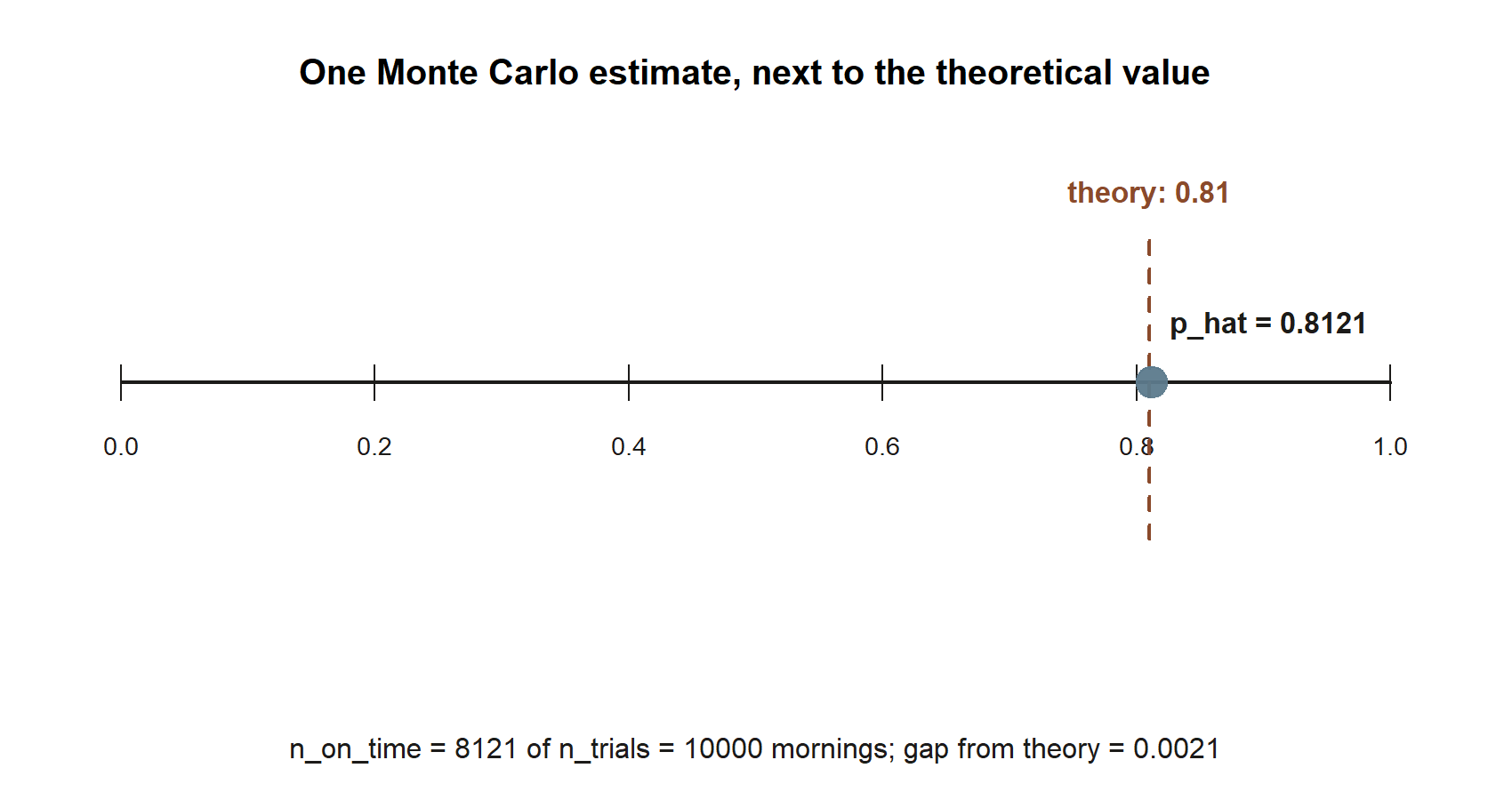

p_late_hat
p_ontime_hat + p_late_hat   # should be exactly 1: the two events partition every morning

With the course seed and n_morn <- 10000, you should get an on-time estimate close to (but not exactly equal to) \(0.81\) — typically within about a percentage point. The last line is a structural check, not a random one: on-time and late are complementary events, so their estimates must sum to exactly \(1\) no matter what the simulation produced.

Step 4 — Watch the estimate settle (a first look at the LLN)

A single estimate from ten thousand mornings is reassuring, but the deeper lesson is how the estimate behaves as the number of mornings grows. The law of large numbers says the running proportion of on-time mornings converges to the true probability \(0.81\) as we accumulate more and more mornings. We can see this directly: form the running mean of on_time — the estimate using just the first morning, then the first two, then the first three, and so on — using cumsum() divided by the running count. Early on the running estimate lurches around; as the morning count climbs it tightens toward \(0.81\).

set.seed(35003)            # re-seed so this block stands alone

n_morn <- 10000
rain    <- rbinom(n_morn, size = 1, prob = 0.30)
on_time <- rbinom(n_morn, size = 1, prob = ifelse(rain == 1, 0.60, 0.90))

# Running estimate of P(on time) after 1, 2, 3, ... mornings
running_est <- cumsum(on_time) / seq_len(n_morn)

# Compare the estimate at a few checkpoints to the exact value 0.81

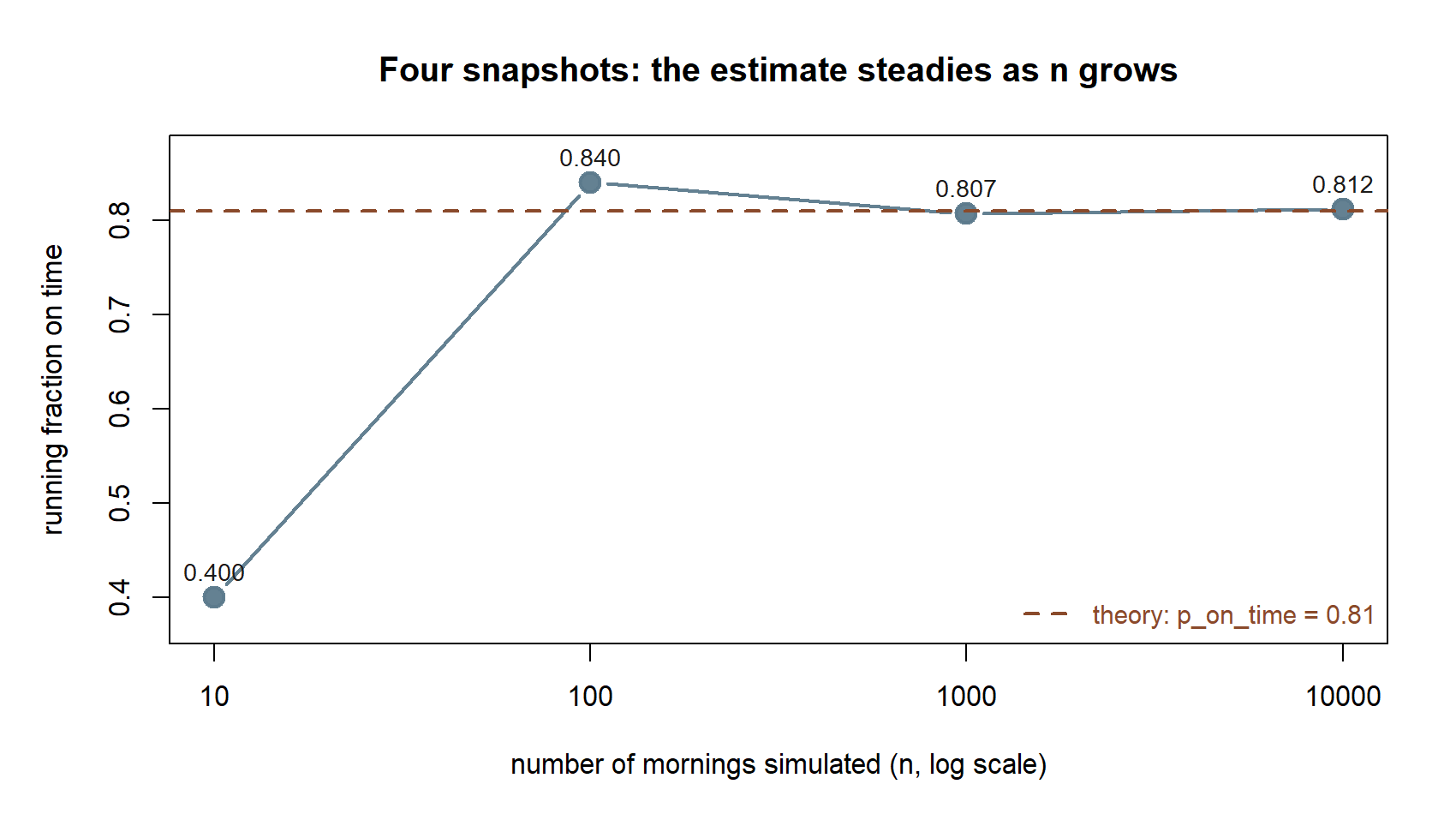

checkpoints <- c(10, 100, 1000, 10000)
data.frame(mornings = checkpoints,
           estimate = round(running_est[checkpoints], 3),
           exact    = 0.81)

# A simple base-R picture of the settling behavior
plot(running_est, type = "l",
     xlab = "number of simulated mornings",
     ylab = "running estimate of P(on time)",
     main = "Estimate settling toward 0.81")
abline(h = 0.81, lty = 2)   # the exact value, for reference

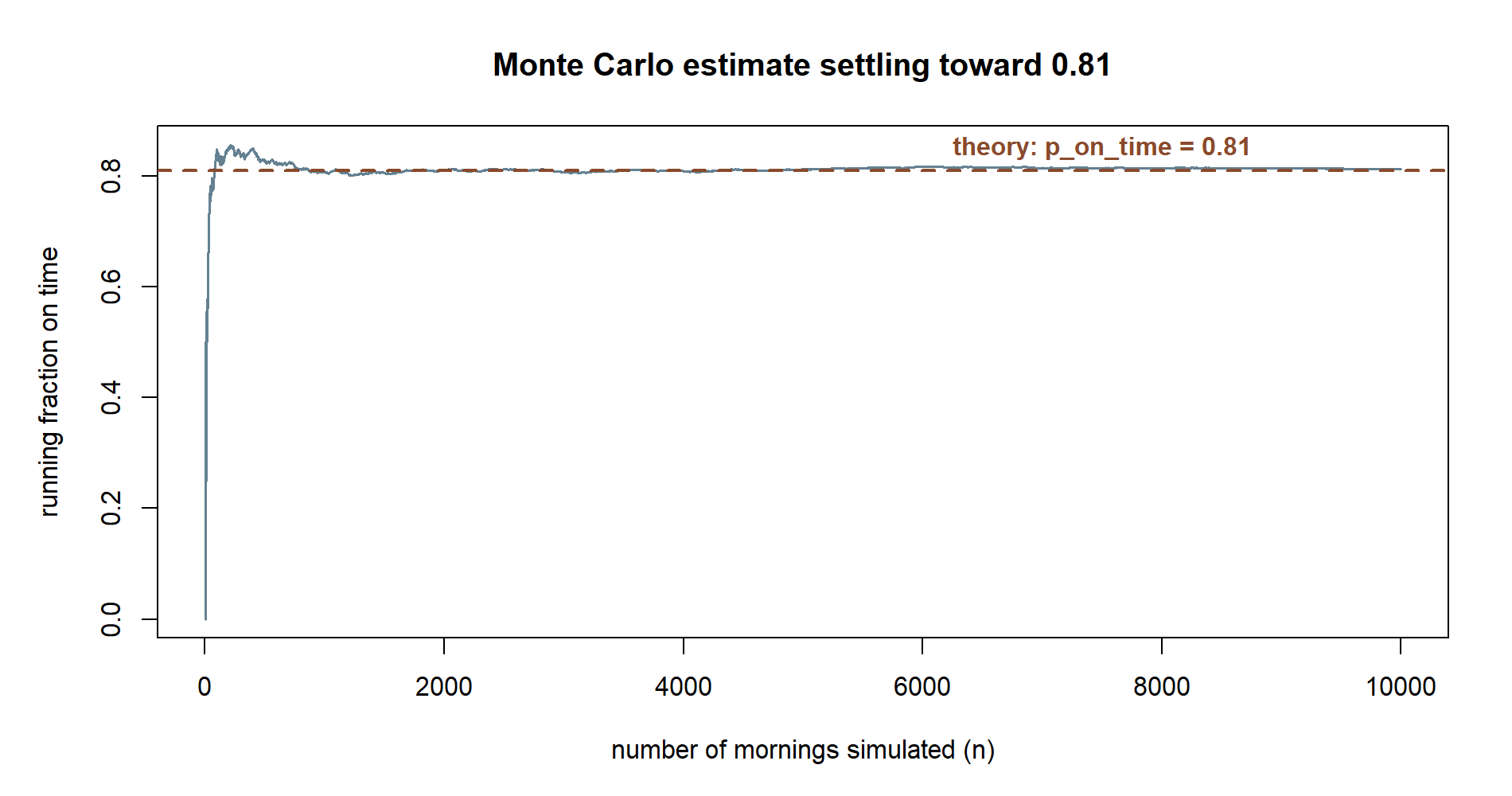

The data frame makes the settling concrete: at 10 mornings the estimate can be far off, but by 1,000 and especially 10,000 mornings it hugs \(0.81\). The plot tells the same story as a picture — a jagged curve early, flattening toward the dashed line at \(0.81\). That convergence is the law of large numbers, and it is the reason a long simulation can stand in for an exact probability when no exact answer is at hand.

Step 5 — Change the world and re-estimate (hands-on)

The simulation tracks whatever world you specify, not just the locked one. Change the inputs and the estimate moves to match. Suppose you wanted to explore a rainier town where the shuttle is also a bit worse in the rain: raise \(P(\text{rain})\) to \(0.50\) and drop \(P(\text{on time}\mid\text{rain})\) to \(0.50\), keeping the dry-day on-time probability at \(0.90\). Before running it, predict the new marginal by hand — \(0.50 \times 0.50 + 0.90 \times 0.50 = 0.70\) — then let the simulation confirm it.

set.seed(35003)

n_morn <- 10000

# New, made-up world (synthetic): rainier, worse shuttle in the rain
p_rain_new        <- 0.50
p_ontime_rain_new <- 0.50
p_ontime_dry_new  <- 0.90

rain_new    <- rbinom(n_morn, size = 1, prob = p_rain_new)
on_time_new <- rbinom(n_morn, size = 1,
                      prob = ifelse(rain_new == 1, p_ontime_rain_new, p_ontime_dry_new))

p_ontime_hat_new <- mean(on_time_new)

# Hand-computed marginal for this new world, to compare against
exact_new <- p_ontime_rain_new * p_rain_new + p_ontime_dry_new * (1 - p_rain_new)

c(estimate = round(p_ontime_hat_new, 3), exact = exact_new)

The simulated estimate should land near \(0.70\), matching your hand calculation for the new world. The takeaway: the machinery is identical — draw the weather, draw the shuttle conditional on the weather, average the indicator. Only the inputs changed. That is what makes Monte Carlo reusable.

Verify

Verification means asking, deliberately, whether the simulation agrees with something you already trust.

  1. Compare to the exact value. For the locked world, the hand answer from Week 2 is \(P(\text{on time}) = 0.81\). Your Step 3 estimate from ten thousand mornings should differ from \(0.81\) by only a small amount — on the order of a percentage point or less. If it were off by, say, \(0.10\), something is wrong: re-check that the conditional probabilities are wired to the right weather (0.60 for rain, 0.90 for no rain, not swapped).
  2. Check the complement. \(\hat P(\text{on time}) + \hat P(\text{late})\) must equal exactly \(1\). This is structural, so it is a check on your code rather than on the randomness.
  3. Check the weather draw. mean(rain) should sit near \(0.30\). If it does not, the rain probability is misspecified and every later number inherits the error.
  4. Read the settling. In Step 4, the estimate at \(10{,}000\) mornings should be visibly closer to \(0.81\) than the estimate at \(10\) mornings. If the running curve is not tightening toward the dashed line, suspect that the seed or the draw is being reset inside the loop.
  5. Re-derive the changed world. In Step 5, the simulation estimate and the hand-computed exact_new should agree to within simulation noise. Agreement across a different set of inputs is stronger evidence the method is right than a single matching number.

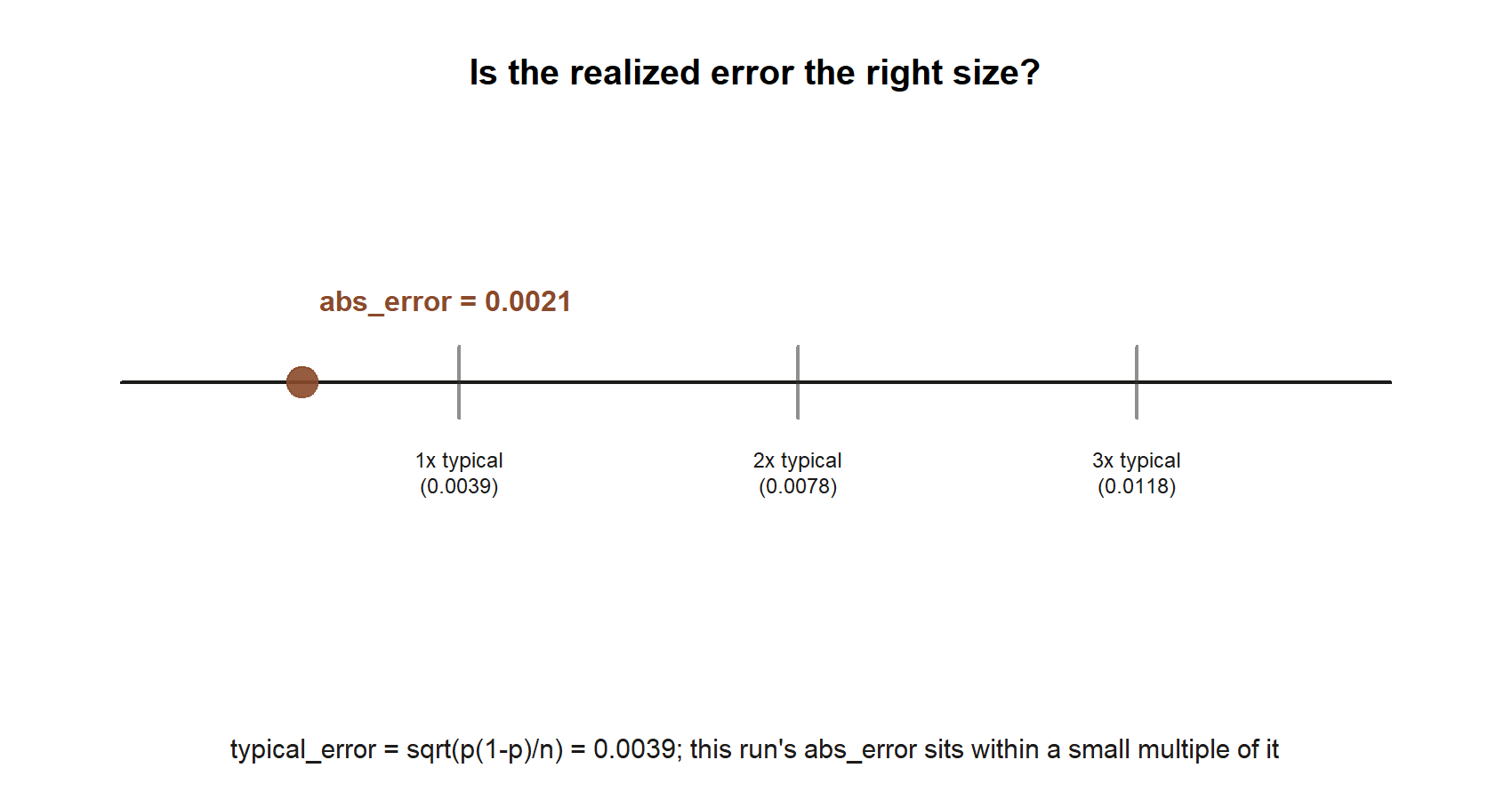

A simulated estimate is never expected to hit the exact value precisely — that small leftover gap is ordinary sampling variability, and it shrinks as you simulate more mornings. The goal is agreement “within noise,” not to the last decimal.
